Financial Management

Schedule of Values (SOV)

Break down your contract into line items for billing and progress tracking.

What Is a Schedule of Values?

A Schedule of Values (SOV) is a detailed breakdown of the total contract value into individual line items. It serves as the foundation for monthly billing (Pay Applications) and progress tracking throughout the project.

Think of it as a comprehensive list of everything included in the contract, with a dollar amount assigned to each item.

Why SOVs Matter

  • Accurate Billing — Pay Applications are built directly from SOV line items
  • Progress Transparency — everyone can see exactly how much work is completed per item
  • Front-Loading Prevention — structured SOVs help prevent overbilling early in the project
  • Audit Trail — approved SOVs create immutable snapshots for financial records

SOV Structure

SOVs follow a three-level hierarchy:

  1. Divisions — major categories of work (e.g., "03 - Concrete", "26 - Electrical")
  2. Subdivisions — subcategories within a division (e.g., "03.10 - Concrete Forming")
  3. Tasks — specific line items with assigned dollar values (e.g., "Foundation Forming - $50,000")

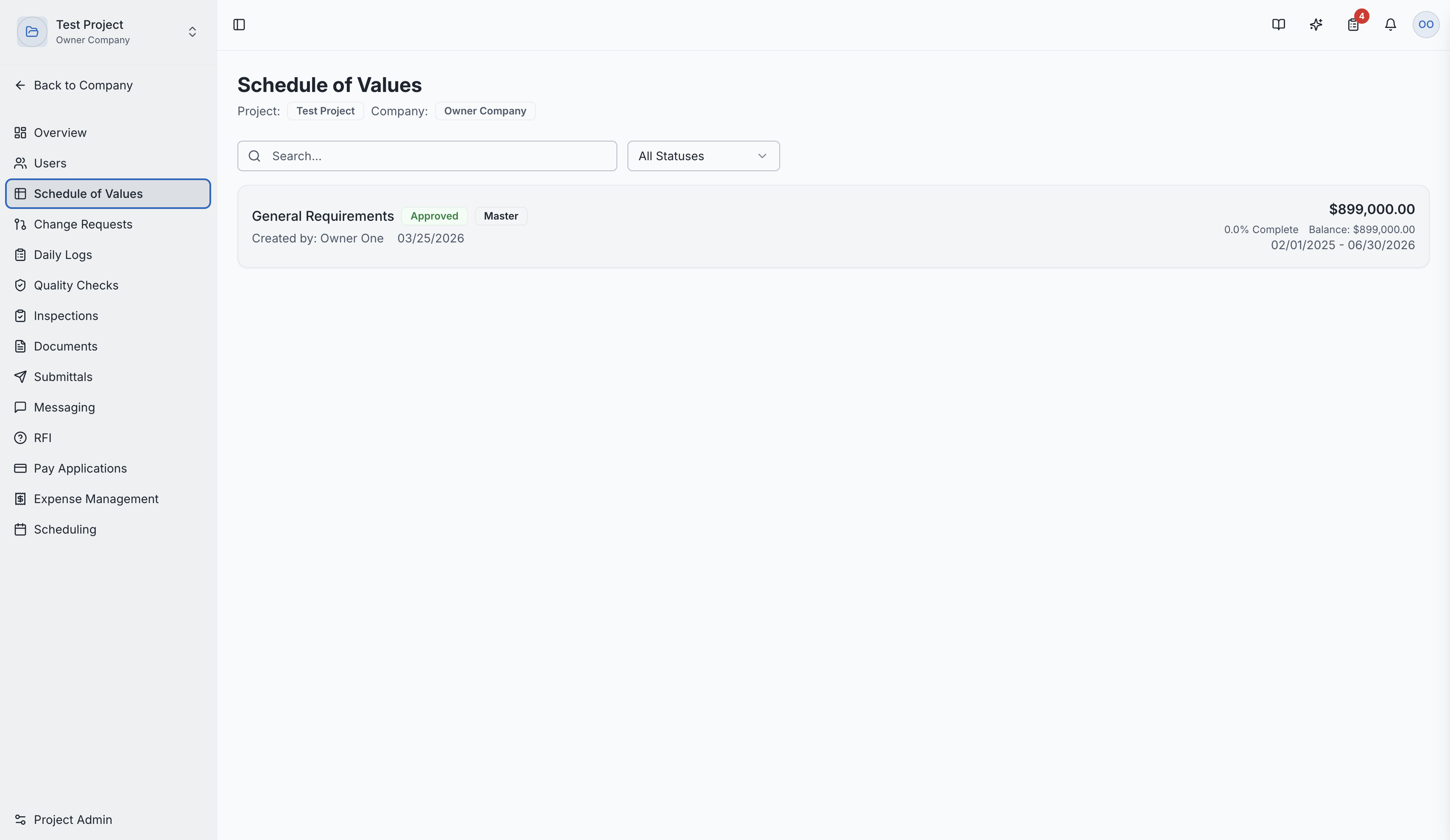

The Schedule of Values list page
The Schedule of Values list page

Creating an SOV

  1. Navigate to Schedule of Values in the project sidebar
  2. Click "Create SOV"
  3. Add Divisions — select from the master division list or create custom divisions
  4. Add Subdivisions — organize work within each division
  5. Add Tasks — assign specific line items with scheduled values (dollar amounts)
  6. Submit for approval when ready

SOV Workflow

StatusDescription
DraftBeing built — can be edited freely
Approval PendingSubmitted for review by the owner/developer
ApprovedLocked — creates an immutable snapshot used for billing
RejectedReturned with feedback for revision
ResubmittedRevised and sent back for another review

Progress Tracking

Once an SOV is approved:

  • Progress is derived from approved Pay Applications (G703 continuation sheet lines)
  • Each line item shows percentage complete and balance to finish
  • The overall SOV shows total scheduled value, completed work, stored materials, and retainage

Versioning

When an SOV is approved, SuperConstruct creates an immutable snapshot. This means:

  • The original approved values are preserved for comparison
  • Changes must go through the Change Request process
  • A complete audit trail is maintained

SOV Detail Page

Clicking any SOV shows the full breakdown:

  • All divisions, subdivisions, and tasks
  • Scheduled values for each line item
  • Progress percentages (if pay applications have been submitted)
  • Balance to finish calculations

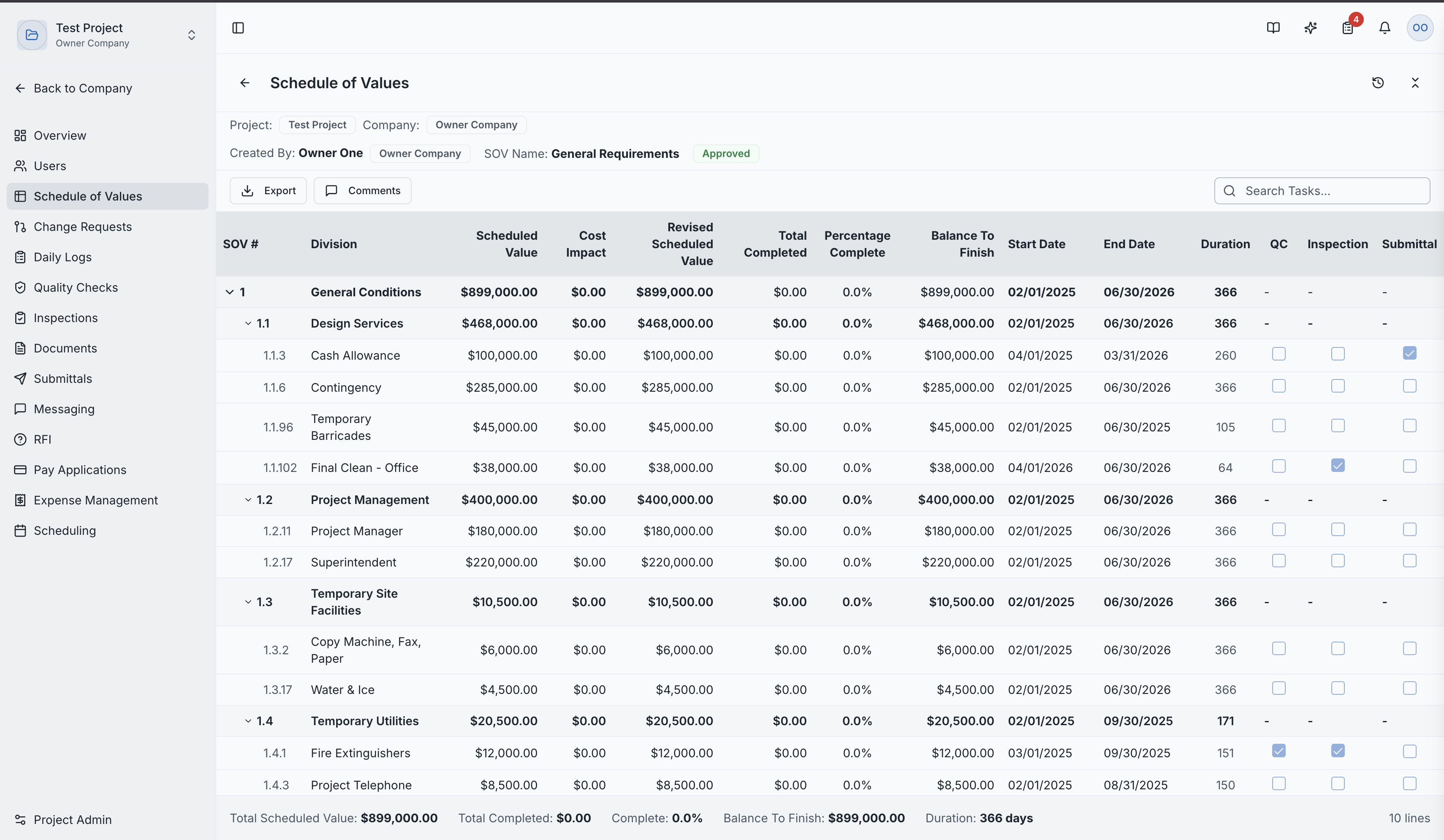

SOV detail showing divisions, tasks, and progress
SOV detail showing divisions, tasks, and progress

Importing an SOV from Excel

If you already have your Schedule of Values in a spreadsheet, you can import it directly instead of entering everything manually.

Step 1 — Download the Template

Click "Import SOV" and then "Download Template" to get the official Excel template (.xlsx). Open it in Excel or Google Sheets and fill in your data.

Template Columns

ColumnRequiredDescription
DivisionYesThe major work category (e.g., "03 - Concrete")
SubdivisionNoA subcategory within the division
TaskYesThe specific line item name
Start DateNoPlanned start date (MM/DD/YYYY)
End DateNoPlanned end date (MM/DD/YYYY)
UOMNoUnit of measure (e.g., SF, LF, EA)
Unit PriceNoPrice per unit
QuantityNoNumber of units

If you provide both Unit Price and Quantity, the scheduled value is calculated automatically (Unit Price × Quantity). Leave both blank to enter a lump-sum value later.

Step 2 — Upload and Preview

  1. Click "Upload File" and select your completed template
  2. The system parses the file and shows a preview table with all imported rows
  3. Rows with missing required fields (Division or Task) are highlighted in red
  4. Review the preview to confirm everything looks correct before proceeding

Step 3 — Create the SOV

Click "Create SOV" to confirm the import. The system will:

  • Auto-create any Divisions, Subdivisions, and Tasks that don't already exist in the project
  • Create the SOV in Draft status so you can review and adjust before submitting for approval
  • Notify relevant project members about the new SOV

Maximum file size: 10 MB. Supported formats: .xlsx and .xls.

Role Access:

RoleAccess Level
General ContractorFull VIEW and MANAGE — create, edit, submit, and import SOVs
GC Project ManagerFull management access
GC SuperintendentFull management access
SubcontractorVIEW and MANAGE their assigned SOV
Owner / DeveloperVIEW — can approve or reject SOVs
GC MemberVIEW only
ArchitectTypically no SOV access

Video Tutorials

How to Create an SOV

How to Reject an SOV

How to Resubmit and Approve an SOV
